BCIS provides life cycle cost benchmark data for buildings that can be used in conjunction with the second edition of the International Construction Measurement Standards (ICMS 2).
In ICMS 1, capital construction costs, associated capital costs and site acquisition and client’s other costs combine to form a total capital cost. In ICMS 2, these costs are viewed from a whole life costs (WLC) perspective. Acquisition costs (AC) appear under the non-construction costs bracket. The life cycle costs (LCC) are:
The life cycle cost section of the BCIS Building Running Costs Online service provides benchmark costs for most building types, covering:
ICMS 2 is a response to industry feedback from ICMS 1, which resulted in the formation of a second independent standards setting committee (SSC) that included experts in life cycle costing. Both editions of ICMS have adhered to a transparent, detailed and inclusive development process, and around 300 comments were received and reviewed during the consultation period for ICMS 2.
Life cycle costs play a key role in the financial management of construction projects. They allow critical decisions to be made relating to longer-term and capital costs that ultimately affect asset performance, longevity, disaster resilience and sustainability. ICMS 2 is a high-level cost model for recording the life cycle costs of a project and the constructed asset.
The life cycle cost section of the BCIS Building Running Costs Online service provides benchmarks by building type that can be adjusted for:
Results can be calculated for:
Results can be calculated at:
The example in Table 1 shows that over 30 years, the cost in use amounts to nearly the same as the capital costs.

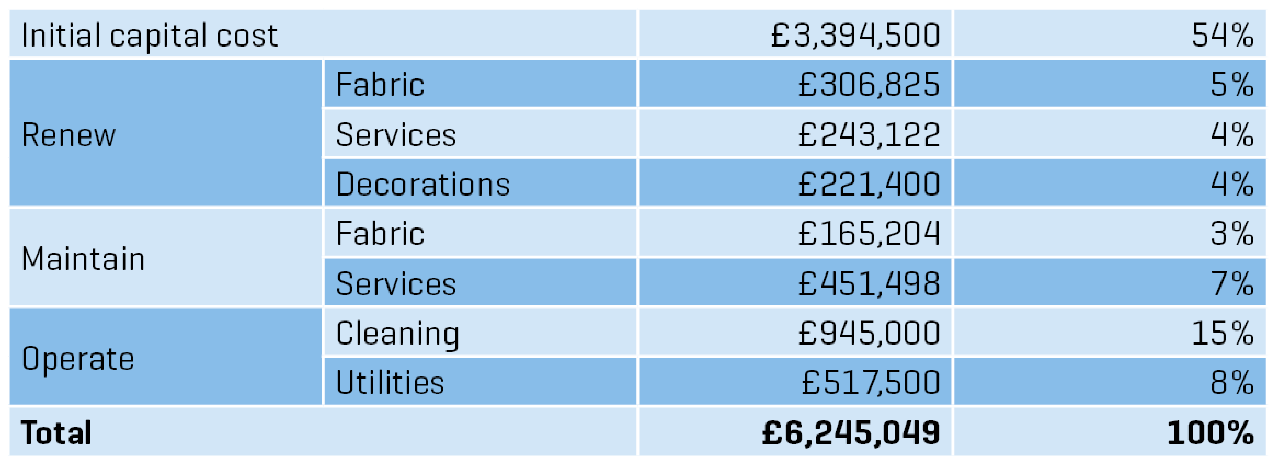

Primary school, 1500m2, 30-year study, life cycle costs at current cash (0 per cent interest)
Costs at 4Q2018 and UK mean location
